We’re moving quickly to enhance your campus experience. Review the projected timeline for Phase 1 construction projects at Johnson County Community College.

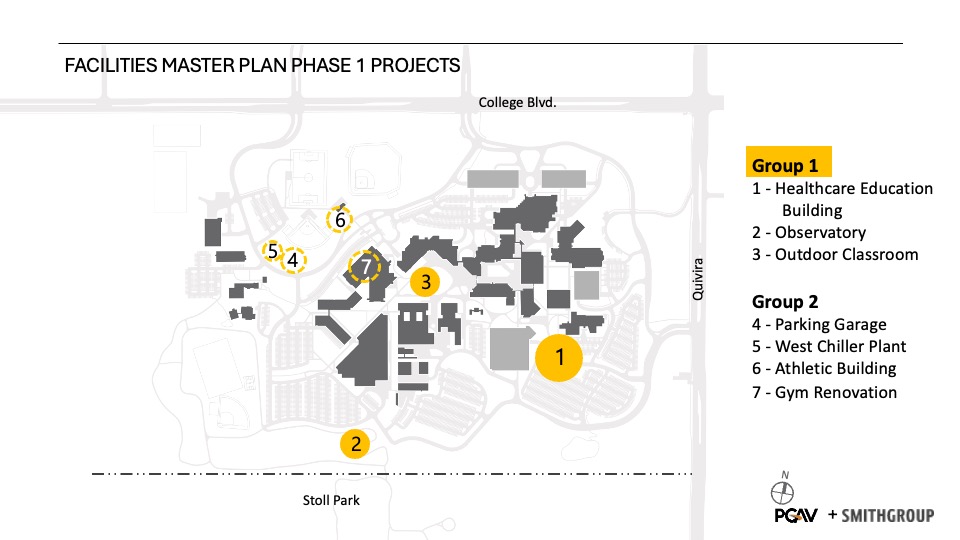

Map

Healthcare Education Building
- Planning & Design: 2026 – 2027
- Construction: Late 2027 – 2028
- Opening for Classes: January 2029
On-Ground Observatory
- Planning & Design: 2026
- Construction: 2027-2028
- Substantial Completion: February 2028
Outdoor Classroom/Amphitheater
- Planning & Design: 2026-2027
- Construction: 2027
- Substantial Completion: January 2028
Our Phase 1 Partners
We’re proud to collaborate with industry leaders to bring these projects to life:
- PGAV – Architects
- McCown Gordon Construction – Construction Manager at Risk (CMaR)
- Smith Group – Collaborative Design Partner and Programming Lead
- Henderson Engineers – MEP/FP Engineer, AV, Acoustics, and Security Designer
- SK Design – Civil Engineer
- Bob D Campbell & Co. – Structural Engineer
- Confluence – Landscape Architect
- Walker Consultants – Parking Garage Functional Designer
